Determine the correct formula and date for the late finish for Activity 2001.
A. LF.2001 - 1 day -> 08-28-01.
B. LS.2002- 1 day-> 08-29-01.
C. LS.2002 + 1 day -> 08-30-01.
D. LS.2002 - 1 day -> 08-28-01.

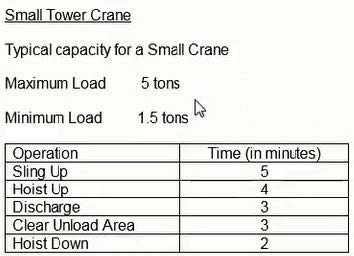

Crane operators require 1 hour prep and 1 hour clean-up and inspection per day. There is only 1 crane operator allocated per crane. Crane operators are not allowed to work more than 8 hours a day. Lunchtime break lasts 1 hour. Assuming a 10 minute cycle time, how many lifts per day can be expected?
A. 36 lifts
B. 24 lifts
C. 30 lifts
D. 48 lifts
Activity 1001 started on the scheduled date but has slipped 10 days. Activity 10002 will slip 35 days. All remaining activities retain their original duration. What is the revised completion date?
A. 02-19-04
B. 03-21-04
C. 03-11-04
D. 03-20-04
In order for a claimant to be entitled to an extension of contract time for a delay event (and further to be considered compensable):
A. The delay must affect the critical path.
B. The delay must be concurrent with the delay attributable to both parties.
C. The delay must not cause monetary harm to the defendant.
D. The delay must affect the contractor's planned construction schedule.

These are the activities on the critical path: A. A, D, and I.
B. A, C, E, and H.
C. A, B, G, and H.
D. A, B, F, and J
In the "normal" schedule, excluding Activity 1000, what activity(s) are concurrent with Activity 3001?
A. 2003 and 7001.
B. 2004.
C. 4001, 5001 and 6001.
D. 4001 and 5001.
If someone wanted to constrain a project's end date so that any project slippage would cause negative float, they would do so by using
A. Finish-no-earlier constraint on the first activity
B. Finish-no-earlier constraint on the last activity
C. Finish-no-later constraint on the last activity
D. Start-no-later constraint on the first activity
If all other work proceeds according to the Baseline plan, how many times will the critical path change?
A. 2.
B. 1.
C. Does not change.
D. 3.
Activity C is a
A. Contentious activity.
B. Continuous activity.
C. 1-day activity.
D. Milestone.
The expected remaining cost needed to complete an activity, group of activities or the project is the____________.
A. Budget at completion (BAC)
B. Budgeted cost of work performed (BCWP)
C. Estimate to complete (ETC)
D. Estimate at completion (EAC)

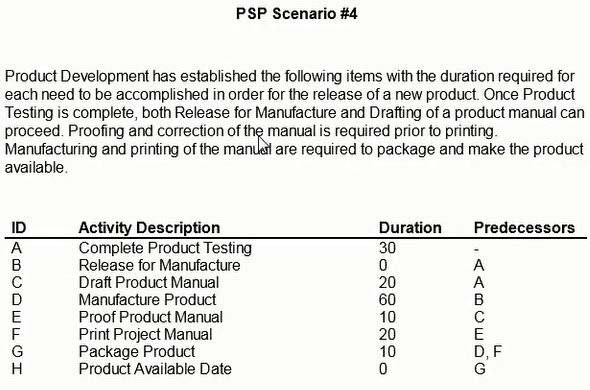

How much Total Float does drafting the product manual have?
A. 15 workdays.
B. 0 workdays.
C. 10 workdays.
D. 5 workdays.
An early start constraint dictates
A. An activity's remaining duration.
B. The planned start of a successor activity
C. The planned start of an activity.
D. The actual start of an activity.
Why does activity 11001 not show successor activities?
A. The early finish and late finish are circular
B. It is the penultimate work required for the project
C. The scheduler forgot to add the successor activities
D. It is the final activity for the required work for the project
If Activity E's duration changes to 4 months, what is the overall duration of the project.
A. 19 months.
B. 20 months.
C. 22 months.
D. 21 months.
A driving relationship is _____________________.
A. A critical relationship.
B. A finish-to-start relationship.
C. The link between two related activities.
D. The link between a predecessor and the activity whose dates it controls.
